Sample Agile Project Plan for Website Redesign

In Agile, projects are broken down into smaller, iterative cycles called sprints. Instead of following a linear path, Agile teams work on incremental progress and adapt to changes throughout the process. Here’s a sample Agile project plan for the same website redesign use case.


Project Overview

Objective: Redesign the company website to improve user experience and optimize it for mobile devices using Agile methodology.

Sprint Structure

  • Sprint Duration: 2 weeks
  • Total Sprints: 6 (with a potential backlog for future sprints)
  • Team Roles: Product Owner, Scrum Master, Development Team, Designers, QA Testers, and Stakeholders.

Backlog Preparation

Product Backlog

The product backlog is a prioritized list of features, bug fixes, improvements, and tasks for the website redesign.

Sample Backlog:

  1. Responsive design for mobile devices.
  2. Improve website load time.
  3. New homepage layout.
  4. User login and registration.
  5. Content management integration.
  6. SEO optimization for all pages.
  7. Bug fixes and testing.

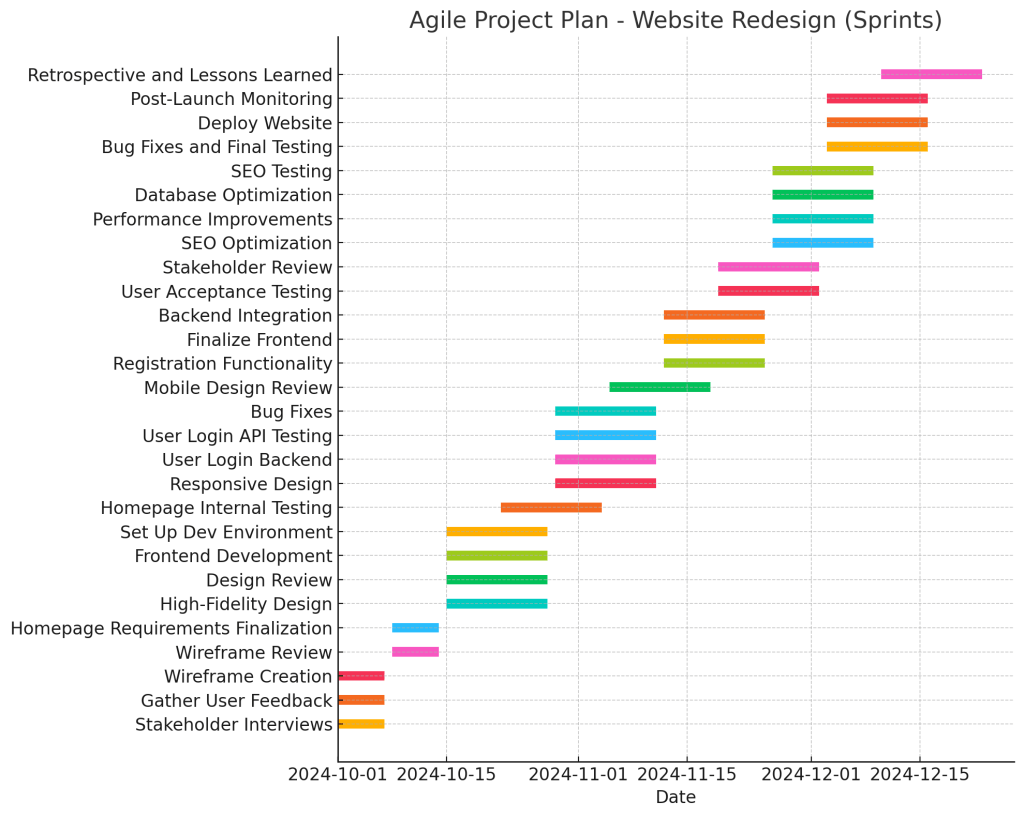

Sprint Plan


Sprint 1: Requirements & Initial Design (2 weeks)

Goal: Gather initial requirements and create the wireframe for the homepage.

Task IDTask NameAssigneeEstimated HoursStory PointsStatus
1.1Conduct stakeholder interviewsProduct Owner10 hours5Done
1.2Gather user feedback for the websiteProduct Owner8 hours3In Progress
1.3Create wireframe for homepageDesigner15 hours8To Do
1.4Review wireframe with stakeholdersScrum Master5 hours3To Do
1.5Finalize requirements for homepage designTeam5 hours2To Do

Sprint Review: Present wireframes and homepage design draft for feedback.


Sprint 2: High-Fidelity Design & Initial Development (2 weeks)

Goal: Finalize homepage design and begin initial frontend development.

Task IDTask NameAssigneeEstimated HoursStory PointsStatus
2.1Create high-fidelity design for homepageDesigner12 hours5Done
2.2Review design with stakeholdersProduct Owner6 hours3Done
2.3Begin frontend development for homepageDeveloper20 hours8In Progress
2.4Set up development environmentDeveloper10 hours5Done
2.5Internal testing of homepage layoutQA Tester8 hours3To Do

Sprint Review: Homepage design completed, initial development demo for the team and stakeholders.


Sprint 3: Responsive Design & Backend Integration (2 weeks)

Goal: Implement mobile responsiveness and begin backend integration for user login functionality.

Task IDTask NameAssigneeEstimated HoursStory PointsStatus
3.1Implement responsive design for homepageDeveloper16 hours5In Progress
3.2Develop user login backend functionalityBackend Dev20 hours8To Do
3.3User login API testingQA Tester12 hours5To Do
3.4Fix bugs from sprint 2 feedbackDeveloper8 hours3To Do
3.5Stakeholder feedback on mobile designScrum Master5 hours2To Do

Sprint Review: Review responsive design and demo basic user login functionality.


Sprint 4: Full Homepage & Backend Completion (2 weeks)

Goal: Finalize homepage design, complete backend for user login, and work on registration.

Task IDTask NameAssigneeEstimated HoursStory PointsStatus
4.1Complete registration functionalityBackend Dev18 hours8To Do
4.2Finalize homepage frontend developmentDeveloper15 hours5To Do
4.3Integrate user login and registrationFull Stack Dev10 hours5To Do
4.4Conduct user acceptance testing (UAT)QA Tester12 hours8To Do
4.5Review with stakeholdersScrum Master5 hours2To Do

Sprint Review: Present completed homepage and user registration functionality for feedback.


Sprint 5: SEO Optimization & Performance Improvements (2 weeks)

Goal: Improve site performance and SEO, optimize for search engines and reduce load times.

Task IDTask NameAssigneeEstimated HoursStory PointsStatus
5.1Implement SEO improvementsDeveloper10 hours5To Do
5.2Reduce website load timesDeveloper15 hours5To Do
5.3Optimize database queriesBackend Dev12 hours5To Do
5.4Test SEO and performanceQA Tester8 hours3To Do

Sprint Review: Show progress on website speed and SEO optimization.


Sprint 6: Final Testing, Deployment, and Project Close (2 weeks)

Goal: Conduct final testing, deploy the website, and project wrap-up.

Task IDTask NameAssigneeEstimated HoursStory PointsStatus
6.1Final bug fixes and testingDeveloper10 hours5To Do
6.2Deploy website to productionDevOps5 hours3To Do
6.3Post-launch monitoringDevOps8 hours5To Do
6.4Retrospective and lessons learnedTeam5 hours2To Do

Sprint Review: Final demo, feedback, and project closure.


Agile Ceremonies

  1. Sprint Planning: Held before each sprint to discuss the backlog and select tasks.
  2. Daily Standups: 15-minute daily meetings to discuss progress, roadblocks, and updates.
  3. Sprint Review: At the end of each sprint, demonstrate progress to stakeholders and gather feedback.
  4. Sprint Retrospective: After each sprint, the team reflects on what went well and what can be improved.

Key Agile Principles in Action

  • Iterative Development: Work is delivered in smaller increments, with constant feedback from stakeholders.
  • Collaboration: Daily interactions between developers, designers, and stakeholders to ensure the project stays on course.
  • Flexibility: Requirements are adapted as new information or feedback emerges after each sprint.
  • Continuous Delivery: Working pieces of the project are delivered after each sprint, allowing the product to evolve.
